Construction equipment can be available on site, consume diesel, record operating hours — and still contribute far less productive output than expected. That gap is where equipment idle time becomes an important construction project-control metric.
Equipment idle time should not be viewed only as an equipment problem. It can indicate gaps in planning, material availability, maintenance, labour coordination, work-front readiness and equipment allocation.
The objective is not simply to keep every machine running. It is to understand:
- When equipment is idle
- Why it is idle
- What that idle time costs
- Whether the idle time is avoidable
- What management can do about it
What Is Equipment Idle Time in Construction?
Equipment idle time is the period during which construction equipment is available or running but is not performing productive work.
For example, an excavator may record 10 operating hours during a shift but perform productive excavation for only 7 hours.
Total Recorded Hours: 10 hours • Productive Hours: 7 hours • Idle Hours: 3 hours
Idle Time % = (Idle Hours ÷ Total Equipment Hours) × 100
For the example: Idle Time % = (3 ÷ 10) × 100 = 30%
A 30% idle-time figure deserves attention. But the percentage alone does not explain why the machine was idle.
Why Does Construction Equipment Sit Idle?
Idle time does not always mean poor equipment performance. A machine may be mechanically healthy and available but unable to work because another project dependency is not ready.

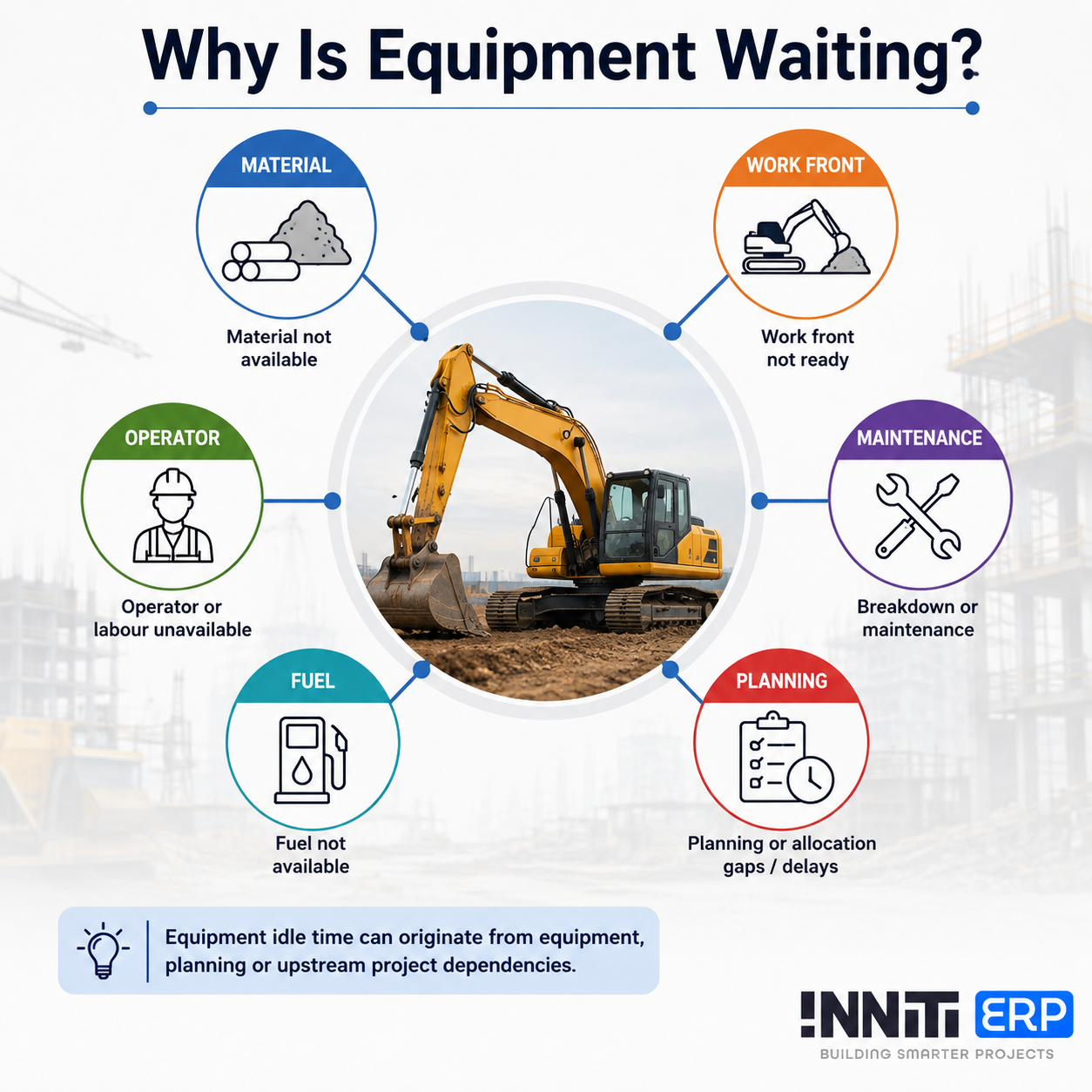

Common causes include:
- Material not available
- Operator or labour unavailable
- Work front not ready
- Waiting for another machine
- Fuel unavailable
- Breakdown or maintenance
- Site-access restrictions
- Drawing or approval delays
- Weather conditions
- Poor equipment allocation
- Shift or activity planning gaps
This distinction is important. If management sees “Excavator idle: 3 hours” it knows what happened. If management sees “Excavator idle: 3 hours — work front unavailable” it begins to understand why it happened and where corrective action may be required.
What Are the Different Types of Equipment Idle Time?
For useful analysis, construction companies should classify idle time by cause.
Expected non-working time from scheduled maintenance, planned shift gaps, standby requirements or other planned operational conditions.
Equipment is available, but another operational dependency prevents productive work — waiting for materials, labour, another machine or site clearance.
Equipment cannot perform its intended work because of breakdown or maintenance requirements.
Idle time caused by preventable planning, coordination, allocation or operational problems — usually deserves the most management attention.
What Is the Real Cost of Equipment Idle Time?
Idle equipment does not necessarily mean zero equipment cost.
Depending on whether equipment is owned or hired, costs may continue through:
This is why equipment performance should not be judged from diesel consumption or operating hours alone. Consider two excavators working during the same 10-hour shift.

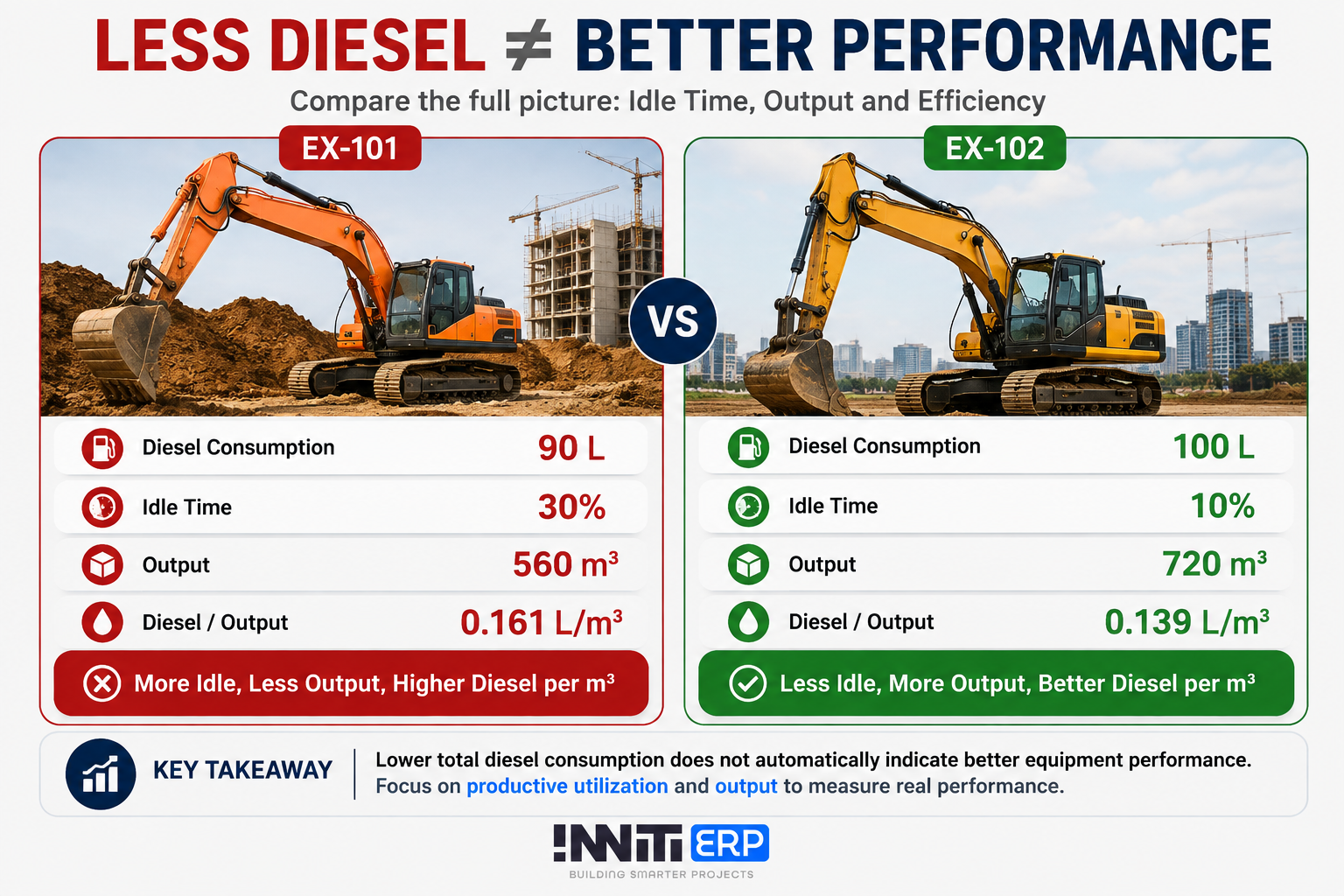

| Metric | EX-101 | EX-102 |
|---|---|---|
| Recorded Hours | 10 hrs | 10 hrs |
| Diesel Consumption | 90 L | 100 L |
| Idle Time | 30% | 10% |
| Output | 560 m³ | 720 m³ |
| Diesel / Output | 0.161 L/m³ | 0.139 L/m³ |
Looking only at diesel consumption could make EX-101 appear more efficient because it consumed 10 litres less. But EX-102 had significantly lower idle time, produced 160 m³ more output, and achieved a better diesel-to-output ratio.
The better management question therefore becomes: Which machine converted its operating resources into productive output more efficiently?
Why Should Idle Time Be Connected With Equipment Output?
Idle-time data becomes considerably more useful when connected with operational output. A useful management relationship is:
This helps management analyse questions such as:
- Which equipment has unusually high idle hours?
- Which projects experience the most avoidable equipment waiting?
- What are the most frequent idle reasons?
- How much diesel is consumed without corresponding output?
- What output is achieved per productive hour?
- What is the equipment cost per unit of output?
- Is the same idle reason recurring across projects?
This changes equipment management from record keeping to performance analysis.
Which Equipment Idle-Time KPIs Should Construction Companies Track?
Construction companies do not necessarily need dozens of equipment KPIs. A focused dashboard can begin with eight.
Total hours during which equipment remained non-productive.
Percentage of total recorded equipment time classified as idle.
Hours during which equipment actually performed its intended activity.
Measures the quantity of work produced for every productive equipment hour.
Measures how much fuel was consumed relative to actual production.
Shows the equipment cost associated with each genuinely productive hour.
Helps management understand the financial effect of non-productive equipment time.
Identifies which causes repeatedly create equipment waiting time — often the most valuable KPI on the list.
Knowing that idle time increased from 12% to 18% tells management that a problem exists. Knowing that 60% of that idle time resulted from work-front unavailability gives management a potential area for corrective action.
How Can Construction ERP Help Control Equipment Idle Time?
Most construction businesses already generate much of the required information: equipment master, HMR/KMR readings, diesel issues, equipment allocation, operator information, maintenance records, breakdown records, project/site allocation, DPR/work progress and equipment output.
The difficulty arises when these records exist independently across registers, spreadsheets or departments.
The store may know how much diesel was issued. The equipment team may know the HMR reading. The site team may know actual work completed. Maintenance may know equipment downtime. Management needs all four perspectives connected.
This is where an integrated construction ERP becomes useful — treating HMR, diesel, maintenance and project progress as parts of the same equipment-performance cycle, instead of separate transactions.
How Inniti ERP Connects Equipment Data With Project Performance
Inniti ERP is a construction ERP designed to connect project, equipment, material, procurement, site and financial information within a common operational system.

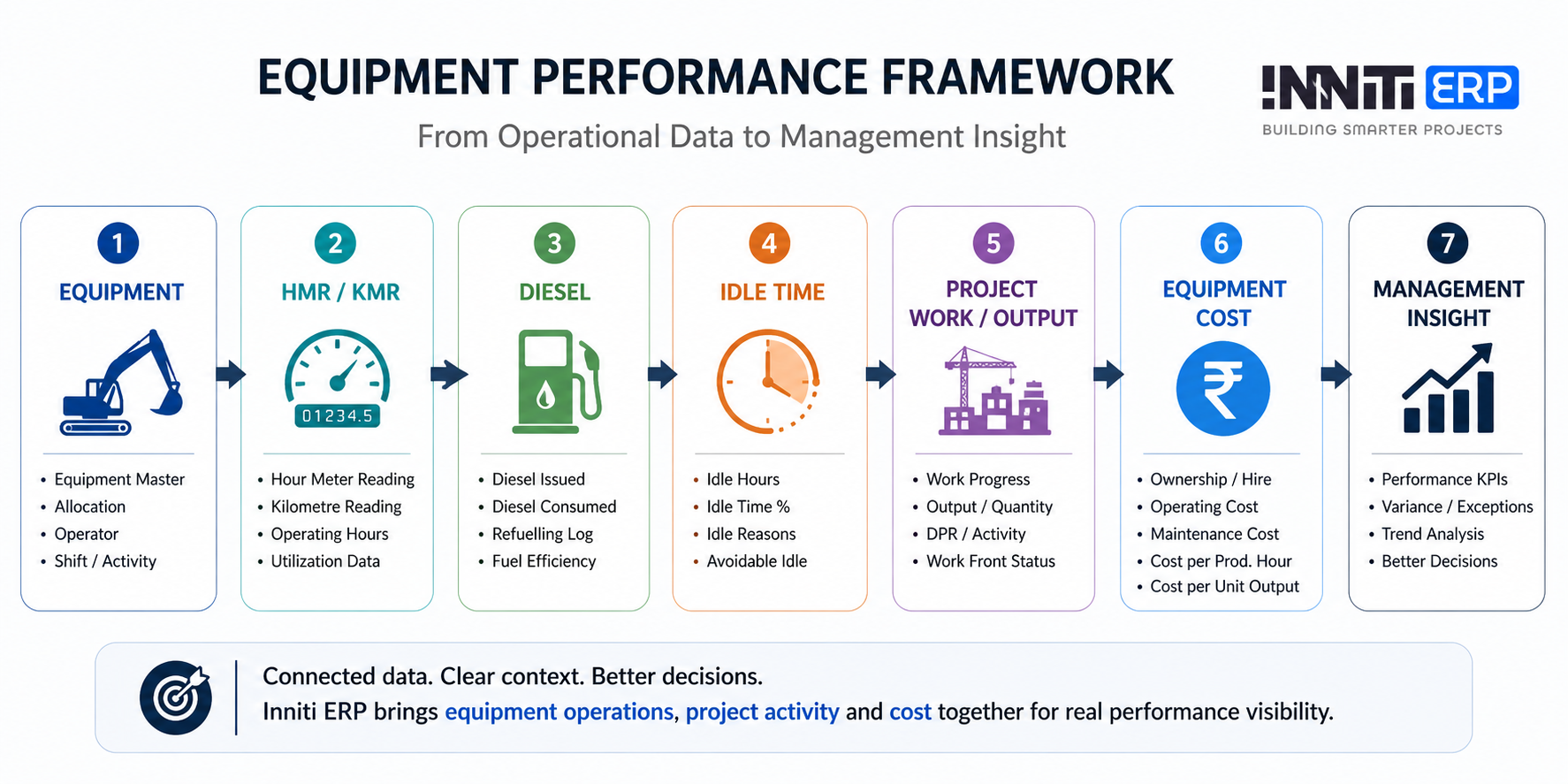

For equipment management, the objective is to connect operational records such as:
This gives construction management greater context when reviewing equipment performance. Rather than reviewing only “EX-101 consumed 90 litres of diesel”, management can analyse: EX-101 → 10 recorded hours → 30% idle → 90 litres diesel → 560 m³ output → associated project/site. The second view provides much more decision-making context.
From Equipment Data to Management Action
The objective of equipment digitization should not stop at creating digital equipment registers. A stronger information flow is:
Data: Excavator recorded 10 hours.
Context: Only 7 hours were productive.
Exception: Idle time reached 30%.
Cause: Work front unavailable for 2 of the 3 idle hours.
Action: Review activity sequencing and work-front planning.
This distinction matters because ERP itself does not reduce equipment idle time. Management reduces idle time. ERP should provide the connected information required to identify where management attention is needed.
A Better Equipment Management Question
Instead of asking:
“How many hours did this excavator run?”
ask:
“How many productive hours did we receive, what output did those hours generate, what did they cost, and why was the remaining time idle?”
That question turns equipment monitoring into project control.
Frequently Asked Questions About Equipment Idle Time
Key Takeaway
Equipment idle time is not simply an equipment metric. It can expose problems across planning, procurement, maintenance, resource allocation and site coordination.
Tracking equipment hours tells management how long a machine was recorded on site. Tracking Hours + Idle Reasons + Diesel + Output + Cost + Project provides a much stronger view of how effectively that equipment contributed to project execution.
For construction companies, the objective should therefore move beyond maintaining an equipment register toward building a measurable equipment-performance management system.
