Equipment Productivity by BOQ Item

Inniti Knowledge Center · Construction · Equipment & Machinery Management

Equipment Productivity by BOQ Item

Your excavator worked 120 hours. Was that good or bad? The number alone cannot answer the question — connect it to the BOQ quantity it produced.

Output, not just hours. Cost per BOQ unit. Planned vs actual. Find the real variance.

Your excavator worked 120 hours. Was that good or bad?

The number alone cannot answer the question.

To understand whether equipment is actually contributing efficiently to a construction project, management needs to connect the equipment resource consumed with the quantity of work produced.

If those 120 productive excavator hours completed 6,000 m³ of an earthwork BOQ item, the project has a measurable output:

Equipment Productivity = 6,000 m³ ÷ 120 hours = 50 m³/hour

If the equipment cost attributable to that work was ₹2,40,000:

Equipment Cost per BOQ Unit = ₹2,40,000 ÷ 6,000 m³ = ₹40/m³

This changes the management question from “How many hours did the machine work?” to “What quantity of BOQ work did those hours produce, and at what equipment cost per unit?”

Quick Answer

Equipment productivity by BOQ item measures the quantity of a specific BOQ work item completed against the equipment resource consumed. It connects equipment hours and cost with measurable work output, allowing contractors to calculate productivity, resource consumption per unit and equipment cost per BOQ unit.

What Is Equipment Productivity in Construction?

Equipment productivity measures the useful work output achieved from equipment over a defined amount of time.

For construction activities, output should preferably be expressed in the unit that represents the work being executed, for example:

Construction WorkPossible Productivity Measure
Earthwork excavationm³/hour
Soil or aggregate haulingm³/hour or tonne/hour
Gradingm²/hour or km/hour
Road material layingtonne/hour
Concrete-related activitym³/hour
Compactionm²/hour or m³/hour

The basic formula is:

Equipment Productivity = Work Output ÷ Productive Equipment Hours

Productivity therefore connects time with physical output.

This is different from simply measuring how long equipment was available or running.

How Do You Calculate Equipment Productivity for a BOQ Item?

To calculate productivity for a BOQ item, associate the equipment hours consumed with the actual executed quantity of that specific BOQ work item.

BOQ Equipment Productivity = Executed BOQ Quantity ÷ Productive Equipment Hours Attributable to the BOQ Item

Example: Earthwork Excavation

Assume a project records:

  • BOQ item: Earthwork excavation
  • Executed quantity: 6,000 m³
  • Productive excavator hours: 120 hours

Then: 6,000 m³ ÷ 120 hours = 50 m³/hour

The measured excavator productivity for this work is therefore 50 m³/hour.

This figure becomes more useful when compared with the project's own planned resource requirement, previous periods, similar work fronts or other relevant internal benchmarks.

Methodology Note

The 50 m³/hour figure above is illustrative. Equipment production rates vary with machine capacity, cycle time, material or soil conditions, lead and lift, operator performance, site constraints, work method and supporting resources. It should not be treated as a universal excavator productivity standard.

Framework connecting BOQ work quantity with equipment resource productivity and equipment cost per unit
BOQ-level equipment analysis connects resource consumption with measurable work output instead of reviewing equipment hours in isolation.

How Do You Calculate Equipment Cost per Unit of Work?

Once equipment usage is connected to actual work output, management can calculate the equipment cost associated with each unit of completed work.

Equipment Cost per BOQ Unit = Equipment Cost Attributable to the BOQ Item ÷ Executed BOQ Quantity

Using the excavation example:

  • Executed quantity = 6,000 m³
  • Attributable equipment cost = ₹2,40,000

₹2,40,000 ÷ 6,000 m³ = ₹40/m³

The equipment component of the executed excavation therefore costs ₹40 per m³ in this illustrative example.

If an hourly equipment cost is already available, another useful relationship is:

Equipment Cost per Unit = Equipment Cost per Hour ÷ Equipment Productivity per Hour

This is why productivity matters to cost control: an hourly equipment rate tells management the cost of time, while output-based measurement tells management what that time produced.

Why Are Equipment Hours Alone Not Enough?

Consider two excavators:

MetricExcavator AExcavator B
Productive hours100 hrs100 hrs
BOQ output5,000 m³6,000 m³
Productivity50 m³/hr60 m³/hr

Both machines recorded the same productive hours.

But they did not deliver the same quantity of work.

If management reviews only machine hours, the difference remains hidden. When those hours are connected to BOQ output, the productivity difference becomes visible.

This does not automatically mean Excavator A performed poorly. The two machines may have worked under different soil conditions, haul arrangements, work fronts, operator conditions or equipment configurations.

The productivity number is a signal for investigation—not a verdict without context.

How Do You Compare Planned vs Actual Equipment Productivity?

This is where BOQ-level equipment analysis becomes particularly valuable.

During estimation or resource planning, a BOQ item may have a planned equipment requirement. During execution, the project can compare that plan with actual equipment consumption and actual output.

Consider this illustrative example:

MetricPlannedActual
BOQ quantity6,000 m³6,000 m³
Excavator hours100 hrs120 hrs
Productivity60 m³/hr50 m³/hr
Equipment cost₹2,00,000₹2,40,000
Equipment cost per m³₹33.33₹40.00

The same 6,000 m³ of work required 20 additional equipment hours compared with the plan.

Productivity changed from 60 m³/hour → 50 m³/hour while equipment cost per unit changed from ₹33.33/m³ → ₹40/m³.

The management issue is therefore not merely that the excavator worked for 120 hours.

The issue is:

Why did this BOQ quantity consume more equipment resource per unit than planned?

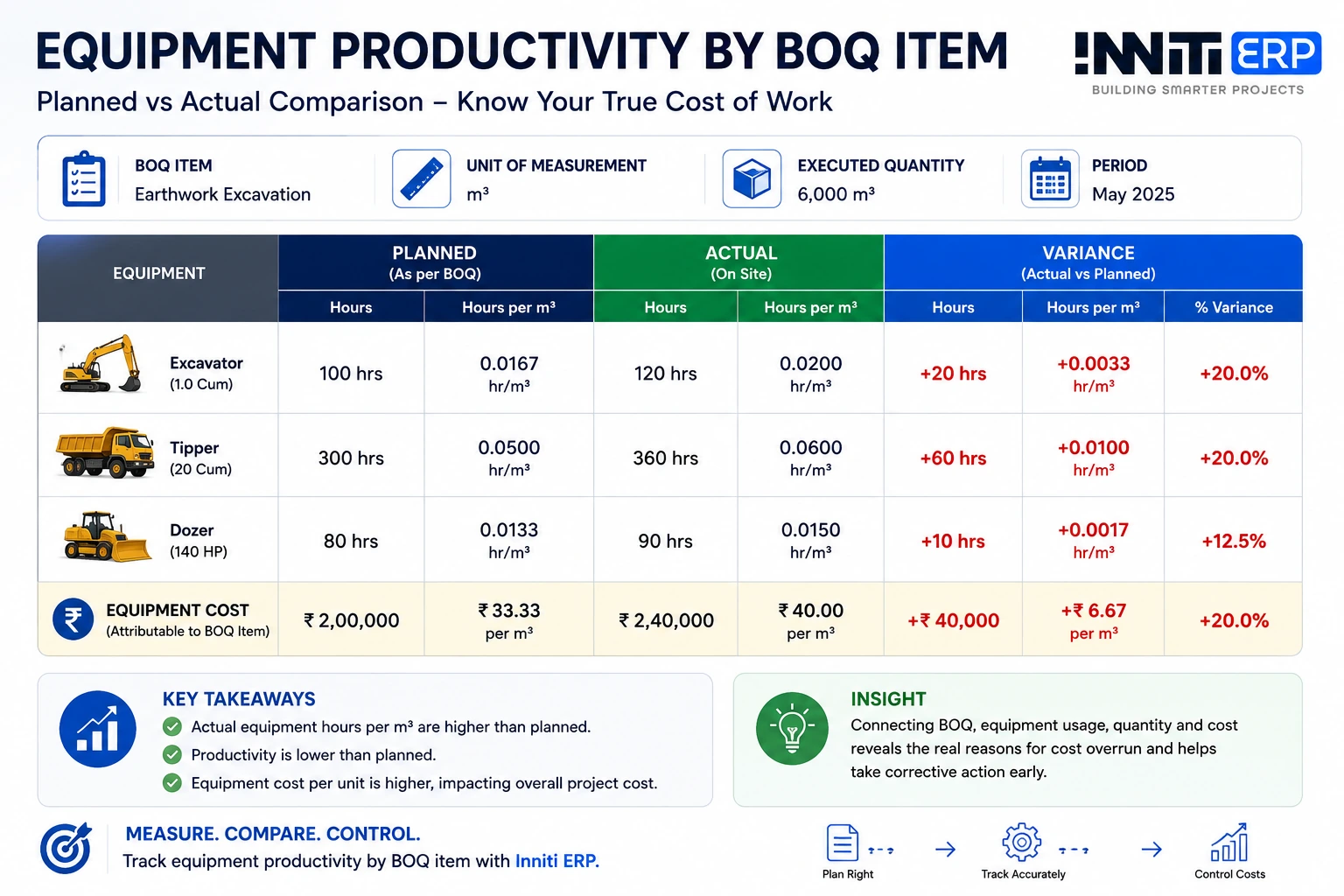

Planned versus actual construction equipment productivity and cost per cubic metre
Comparing planned and actual resource consumption shows whether a BOQ item is consuming more equipment hours and cost per unit than expected.

How Do You Calculate Actual Equipment Hours per BOQ Quantity?

Sometimes the most useful productivity measure is expressed in reverse—as resource consumption per unit of work.

Equipment Hours per BOQ Unit = Actual Equipment Hours ÷ Actual BOQ Quantity

For the same example:

120 hours ÷ 6,000 m³ = 0.020 equipment hour/m³

If the plan allowed:

100 hours ÷ 6,000 m³ = 0.0167 equipment hour/m³

the project is consuming more excavator time per m³ than planned.

This format can be especially useful when the BOQ estimate or resource analysis is already expressed as equipment hours per unit.

Why Can Equipment Utilization Be High but Productivity Be Low?

Because utilization and productivity answer different questions.

Utilization asks: Was the equipment being used during the time it was available?

Productivity asks: How much useful work output did the equipment produce during the relevant working time?

A machine may record substantial operating or productive hours while producing less output than expected because of:

  • longer cycle times;
  • difficult ground or material conditions;
  • constrained work fronts;
  • inefficient loading or hauling coordination;
  • operator performance;
  • unsuitable equipment selection;
  • rework;
  • sequencing constraints;
  • supporting equipment imbalance.

For this reason, utilization should not be used as a substitute for work-output productivity.

Related reading: Equipment Utilization in Construction.

How Does Equipment Productivity Affect Construction Cost?

Equipment cost is often time-based: ownership cost, rental, operating cost or another internally defined hourly cost accumulates as equipment time is consumed.

If more equipment hours are required to produce the same quantity of work, the equipment cost per unit can rise.

For example:

Scenario A

100 equipment hours × ₹2,000/hour = ₹2,00,000
Output = 6,000 m³
Equipment cost = ₹33.33/m³

Scenario B

120 equipment hours × ₹2,000/hour = ₹2,40,000
Output = 6,000 m³
Equipment cost = ₹40/m³

The hourly rate did not change.

The resource consumption required for the work changed.

That is why a contractor can experience BOQ cost pressure even when equipment rental or hourly operating rates remain unchanged.

What Can Cause Actual Equipment Consumption to Exceed the BOQ Plan?

A productivity or resource variance should trigger investigation into the work conditions behind the number.

Common causes can include:

1. Different Site Conditions

Soil, terrain, access, working space, lead, lift or other physical conditions may differ from the assumptions used during planning.

2. Equipment Mismatch

The deployed equipment capacity or configuration may not suit the work front as effectively as the planned resource.

3. Supporting-Resource Imbalance

An excavator may be capable of higher output but still be constrained by inadequate tippers, delayed material movement or downstream capacity.

4. Work-Front or Sequencing Constraints

Frequent interruptions, restricted access or fragmented work can reduce output even when the equipment itself is operational.

5. Operator and Cycle-Time Variation

Loading, travel, positioning, dumping and return-cycle performance directly affect repetitive equipment production.

6. Rework or Non-BOQ Productive Activity

Equipment time may be consumed on work that does not translate directly into measurable BOQ progress.

7. Incorrect Attribution

If equipment hours are booked to the wrong project activity or BOQ item, the calculated productivity itself becomes misleading.

The purpose of BOQ-level measurement is therefore not just to generate another KPI. It is to give project teams a structured way to identify where resource consumption differs from plan and where investigation is required.

How Should Equipment Cost Be Tracked Against BOQ Items?

A practical BOQ-level equipment control process needs more than an equipment log.

The project should be able to connect:

1. BOQ Item

What work is being executed?

2. Planned BOQ Quantity

How much work is planned?

3. Planned Equipment Resource

What equipment type and resource quantity were considered?

4. Actual Equipment Deployment

Which equipment worked against the activity?

5. Actual Equipment Hours

How much relevant equipment time was consumed?

6. Executed BOQ Quantity

How much measurable work was completed?

7. Equipment Cost

What attributable equipment cost was incurred?

8. Variance

How does actual resource consumption and cost per unit compare with the plan?

This creates a much stronger project-control chain than treating the equipment department and BOQ/project-cost system as separate information islands.

One Machine Can Work Against Multiple BOQ Items

BOQ-level productivity requires proper attribution.

An excavator may perform:

  • roadway excavation in the morning;
  • drain excavation later;
  • loading or disposal support afterward.

Recording eight hours only against the excavator tells management how long the machine worked.

It does not necessarily tell management which work consumed those eight hours.

Where practical, equipment usage should therefore be associated with the relevant project activity, cost code, BOQ item or other execution reference used by the contractor.

Otherwise, BOQ-level productivity and unit-cost analysis may be distorted.

What Data Should Be Captured at Site?

The exact process depends on the contractor's operating model, but useful data can include:

  • project and location;
  • date and shift;
  • equipment ID and equipment type;
  • BOQ item / activity / cost code;
  • opening and closing HMR or KMR where applicable;
  • productive or attributable hours;
  • executed work quantity;
  • unit of measurement;
  • operator or responsible person;
  • relevant work-front information;
  • supporting remarks for abnormal conditions.

The goal is not to collect maximum data.

The goal is to capture enough reliable, consistently classified data to connect equipment resource consumption with actual work output.

From Equipment Tracking to BOQ-Level Cost Control

Traditional equipment reporting may answer: Which machine worked? For how many hours? What diesel was issued? What did the equipment cost?

Those are important questions.

BOQ-level analysis adds another layer:

Which work consumed the equipment resource, how much output did it produce, and how did the resulting unit cost compare with the plan?

This turns equipment data into project-cost context.

How Inniti ERP Connects Equipment Productivity with BOQ Work

Inniti ERP is designed around connected construction project information.

Where project processes and configurations support it, BOQ/resource planning can be connected with actual site execution and equipment information so that teams can analyse the relationship between:

BOQ Item
Planned Resource
Actual Usage
Executed Quantity
Equipment Cost
Variance

This allows management to move beyond equipment-hour reporting and review questions such as:

  • Which BOQ items are consuming more equipment hours than planned?
  • What is the actual equipment resource consumption per unit of work?
  • How does actual productivity compare with the planned resource assumption?
  • Which activities show increasing equipment cost per unit?
  • Is a cost variance coming from rate, resource consumption, output, or a combination?
  • Which work fronts require management investigation?

Inniti ERP does not make every project condition identical, nor does software itself create equipment productivity.

Its role is to help connect operational and project data so that management can identify variance earlier and investigate it with better context.

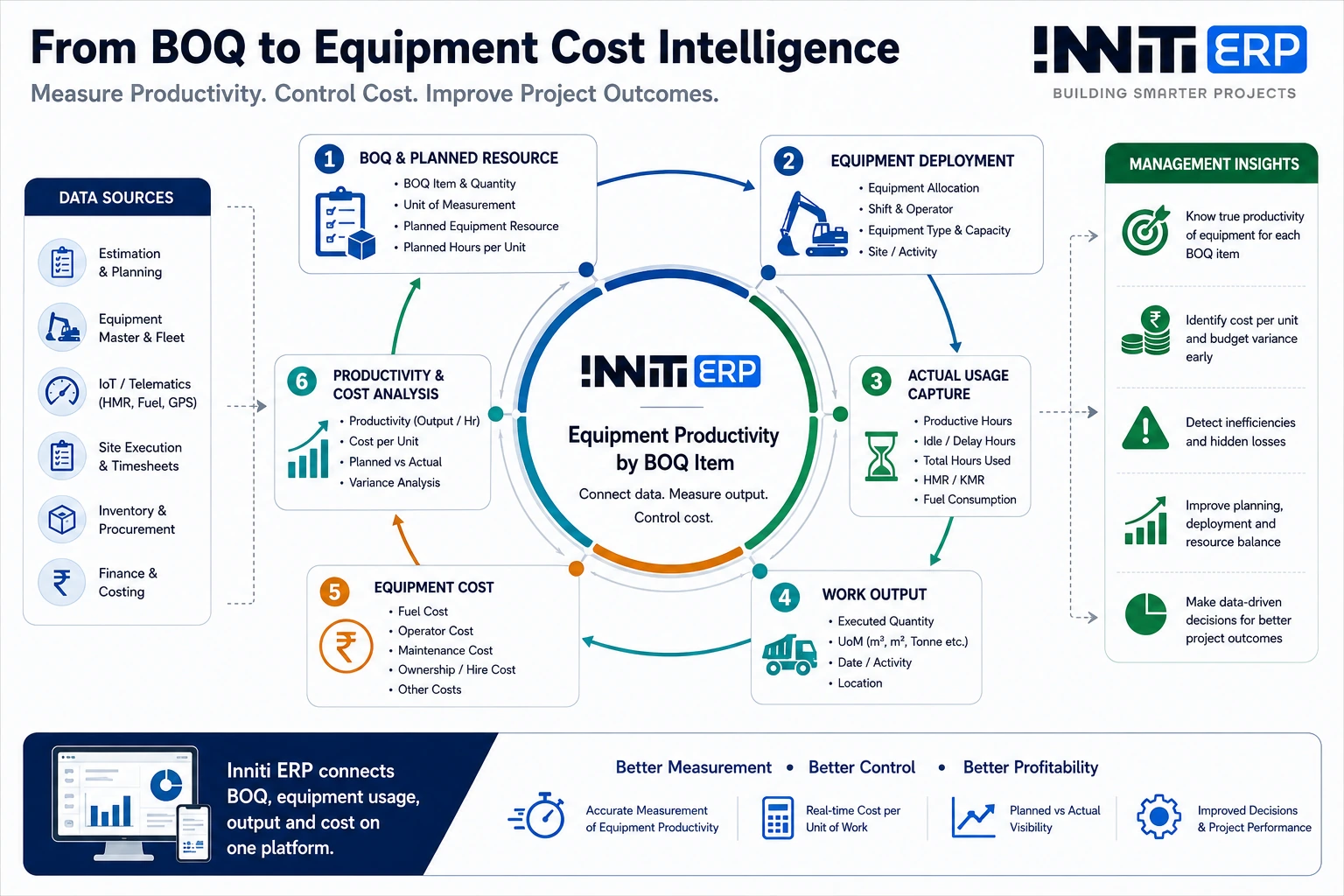

Inniti ERP framework connecting BOQ items with planned and actual equipment resource consumption
Connecting BOQ planning, equipment usage, work output and cost helps management analyse resource consumption at the level where project work is actually measured.

A Simple Management View

The most useful equipment dashboard is not always the one with the largest number of machine KPIs.

For BOQ productivity, management may start with five questions:

1. What quantity was planned?
2. What equipment resource was planned for that quantity?
3. What quantity has actually been executed?
4. How much equipment resource and cost has actually been consumed?
5. What is the resulting productivity and cost per BOQ unit?

If the answer to question five is moving away from the plan, the project team knows where to investigate.

Common Mistakes When Measuring Equipment Productivity

Comparing Unlike Work Conditions

Two productivity figures are not automatically comparable simply because the equipment type is the same.

Using Total Machine Hours Without BOQ Attribution

Hours spent on different activities can distort item-level productivity.

Treating Operating Hours as Physical Output

Machine movement or operation does not automatically mean measurable BOQ progress.

Ignoring Supporting Resources

Equipment productivity can depend on an entire operating cycle, not one machine in isolation.

Using One Benchmark as a Universal Standard

Project conditions matter. Internal planned values and comparable historical work should be interpreted with engineering judgment.

Looking Only at Cost After the Work Is Finished

Productivity and resource-consumption trends are more useful when reviewed while work is still in progress and management still has options to respond.

Frequently Asked Questions

Equipment productivity is the quantity of useful construction work produced for a defined amount of equipment time. Depending on the activity, it may be measured as m³/hour, tonne/hour, m²/hour or another physical output unit.
Divide the measurable work output by the productive equipment hours used to achieve that output. Equipment Productivity = Work Output ÷ Productive Equipment Hours.
Associate equipment hours with a specific BOQ item and divide the executed quantity of that item by the productive equipment hours attributable to it.
Divide the equipment cost attributable to excavation by the actual excavation quantity completed. Equipment Cost per m³ = Excavation Equipment Cost ÷ Executed Excavation Quantity.
It is the equipment cost attributable to producing one unit of work. It can be calculated by dividing total attributable equipment cost by output, or by dividing equipment cost per hour by equipment productivity per hour when both measures use a consistent basis.
Compare planned resource consumption or planned productivity for a BOQ quantity with the actual equipment hours and actual output recorded during execution. The difference can be analysed as productivity variance, hours-per-unit variance or equipment-cost-per-unit variance.
Utilization measures whether equipment time is being used, while productivity connects equipment time with actual output. A machine can be highly utilized but produce less work because of long cycle times, site constraints, supporting-resource delays, unsuitable deployment or other operating conditions.
When more equipment time is consumed to produce the same quantity of work, equipment cost per unit can increase even if the equipment's hourly rate remains unchanged.
They need a consistent link between the BOQ item, planned equipment resource, actual equipment usage, executed quantity and attributable equipment cost. This allows productivity and cost per BOQ unit to be compared with the plan.
No. Lower productivity can result from equipment condition, but it can also come from soil or material conditions, work-front restrictions, cycle-time changes, operator factors, supporting-resource imbalance, sequencing, rework or incorrect data attribution. The variance should be investigated in context.
See BOQ-Level Equipment Cost Control in Inniti ERP You may already know what your equipment costs. Do you know which BOQ item consumed that cost? Inniti ERP can connect construction BOQ/resource planning with actual equipment usage, work quantities and cost information to give management stronger planned-vs-actual visibility.

Key Takeaway

Construction equipment becomes more meaningful to cost control when its resource consumption is connected with measurable BOQ work output.

Instead of stopping at: “The excavator worked 120 hours.”

ask: “What BOQ quantity did those 120 hours produce?”

and then: “What equipment cost did we incur per unit of that work compared with what we planned?”

That is the difference between tracking equipment and using equipment data for project cost control.
