A construction project may plan one excavator and three dumpers for an activity.
But what if the site actually uses one excavator and five dumpers?
The additional equipment is not automatically inefficient. Site conditions, haul distance, productivity requirements, schedule recovery or changes in execution strategy may justify it.
The real management problem begins when the organisation cannot answer:
- What equipment was originally planned?
- What equipment was actually deployed?
- How many hours or days was it used?
- Which BOQ/WBS activity consumed those resources?
- What output was achieved?
- Why did actual equipment usage differ from the plan?
- What is the resource and cost implication of that variance?
This is the difference between simply tracking equipment and managing equipment as a project resource.
Quick answer: Planned vs actual equipment utilization compares the machinery resources expected for a BOQ/WBS activity with the equipment actually deployed during execution. When actual hours, quantities, output and cost context are connected with the original resource plan, project teams can identify and investigate equipment-resource variances.
Editorial & methodology note: The calculations in this article are simplified examples intended to explain equipment resource variance. Actual planning, operating-hour definitions, allocation rules and costing methods may vary by organisation, contract, equipment type and project methodology. A variance identifies a difference requiring context; it does not automatically prove inefficiency or cost overrun.
Why Planned vs Actual Equipment Tracking Matters
Equipment planning usually begins before site execution.
During estimation, budgeting or project planning, resources may be defined for an activity based on expected quantities, productivity, equipment capacity, execution methodology, project duration, working hours, and resource requirements.
Once execution begins, actual conditions can be different. A project may use more equipment than planned, less equipment than planned, different equipment than planned, or planned equipment for more hours or days than expected.
Without connecting the original resource plan with actual equipment deployment, management sees only one side of the story.
What Is Planned Equipment Utilization?
Planned equipment utilization represents the equipment resources expected to be required for executing a defined project activity, WBS element or BOQ item.
Depending on the organisation's planning methodology, the plan may define equipment type, equipment quantity, expected hours, expected days, productivity assumptions, resource rate, expected output, and estimated equipment cost.

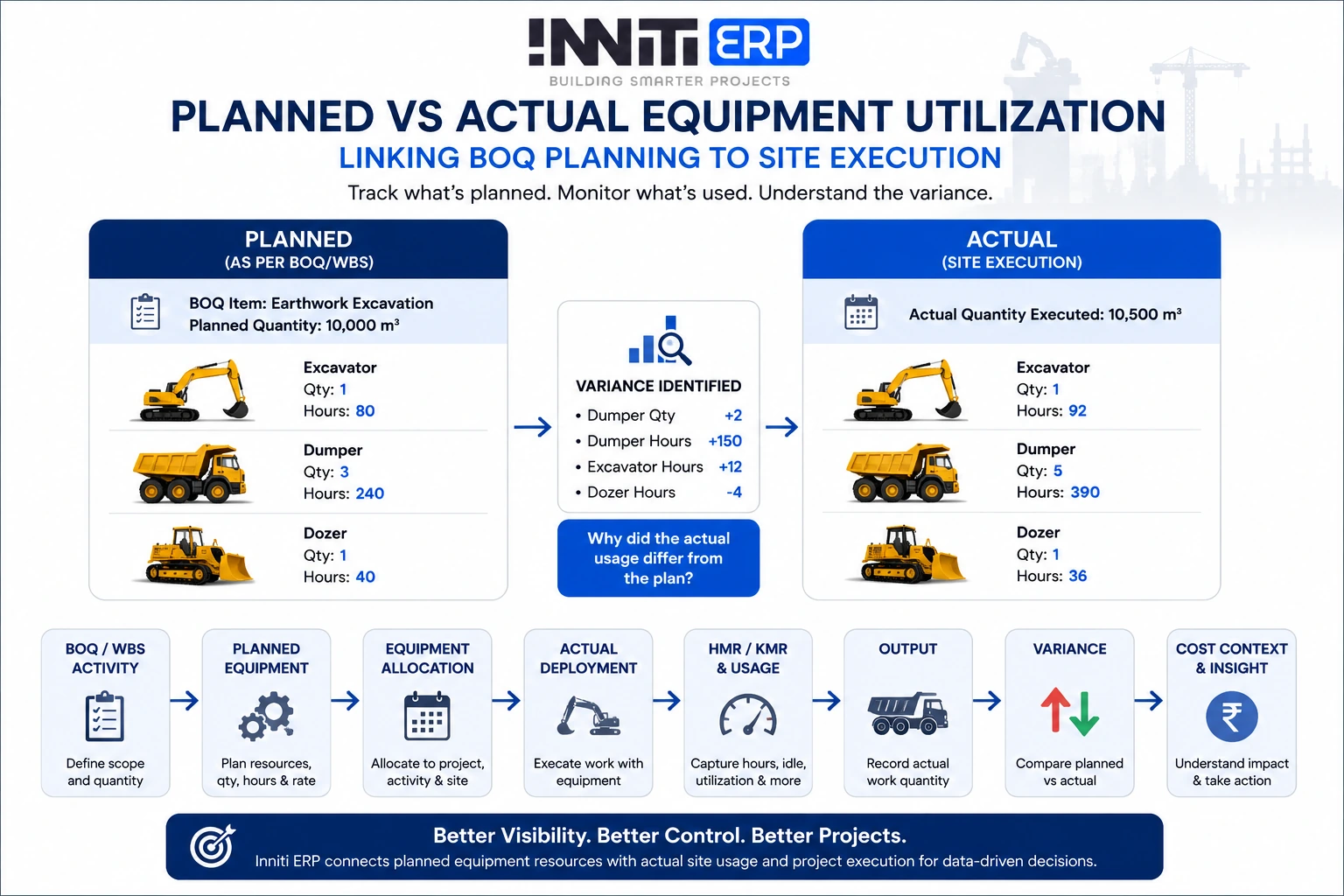

For example, consider an earthwork activity.
| Resource | Planned Qty | Planned Usage |
|---|---|---|
| Excavator | 1 | 80 hours |
| Dumper | 3 | 240 combined hours |
| Dozer | 1 | 40 hours |
This creates a resource baseline against which actual execution can later be compared.
What Is Actual Equipment Utilization?
Actual equipment utilization represents the equipment resources actually deployed and consumed during project execution.
Actual usage may be derived from operational records such as equipment allocation, HMR/KMR, daily equipment logs, productive hours, working hours, idle time, deployment days, project/site allocation, and completed work quantities.
For the same activity, actual execution might look like this:
| Resource | Planned Qty | Actual Qty | Planned Hours | Actual Hours |
|---|---|---|---|---|
| Excavator | 1 | 1 | 80 | 92 |
| Dumper | 3 | 5 | 240 | 390 |
| Dozer | 1 | 1 | 40 | 36 |
The question is no longer merely:
How many hours did the equipment operate?
It becomes:
Why did actual equipment consumption differ from the resources planned for this activity?
That is a project-control question.
What Is Equipment Resource Variance?
Equipment resource variance is the difference between planned equipment usage and actual equipment usage for a defined scope of work.
At its simplest:
If an excavator was planned for 80 hours but actually operated for 92 hours:
Percentage variance can be expressed as:
Therefore: (92 − 80) ÷ 80 × 100 = +15%
The excavator consumed 15% more hours than planned.
But this figure alone does not establish poor performance. That distinction is important.
Is Higher-Than-Planned Equipment Usage Always Inefficient?
No. Higher actual equipment usage does not automatically mean the equipment or project performed inefficiently.
Suppose planned excavator usage = 80 hours and actual excavator usage = 92 hours.
Actual usage may have increased because executed quantity increased, soil conditions changed, haul distance changed, work methodology changed, productivity assumptions were unrealistic, additional work was instructed, equipment capacity differed, schedule acceleration was required, or operational constraints affected execution.
Equipment variance identifies where management should investigate. It does not, by itself, explain why the variance occurred.
This is why planned-versus-actual reporting becomes more useful when connected with actual output and project context.
How Does BOQ-Level Equipment Tracking Improve the Analysis?
Consider a BOQ item: Earthwork Excavation — BOQ Quantity: 10,000 m³.
During planning, the resource requirement is estimated as 1 Excavator + 3 Dumpers. During execution: 1 Excavator + 5 Dumpers.
A simple equipment register tells management that five dumpers were used. A BOQ-linked equipment-management system can provide more context:
This makes equipment data part of project control rather than an isolated machinery record.
Equipment Quantity Is Only the First Layer
Tracking whether three or five dumpers were deployed is useful, but equipment count alone does not explain resource consumption.
Management can progressively analyse:
How many machines were planned versus actually deployed?
For how many days was equipment planned versus actually deployed?
How many operating hours were expected versus recorded?
How much of the actual equipment time contributed to productive work?
What quantity was actually completed using those resources?
What was the financial impact of the equipment resources consumed?
Together, these provide a stronger view of equipment performance.
What Should a Planned vs Actual Equipment Report Show?
A useful planned-versus-actual equipment report can allow project teams to review information such as:

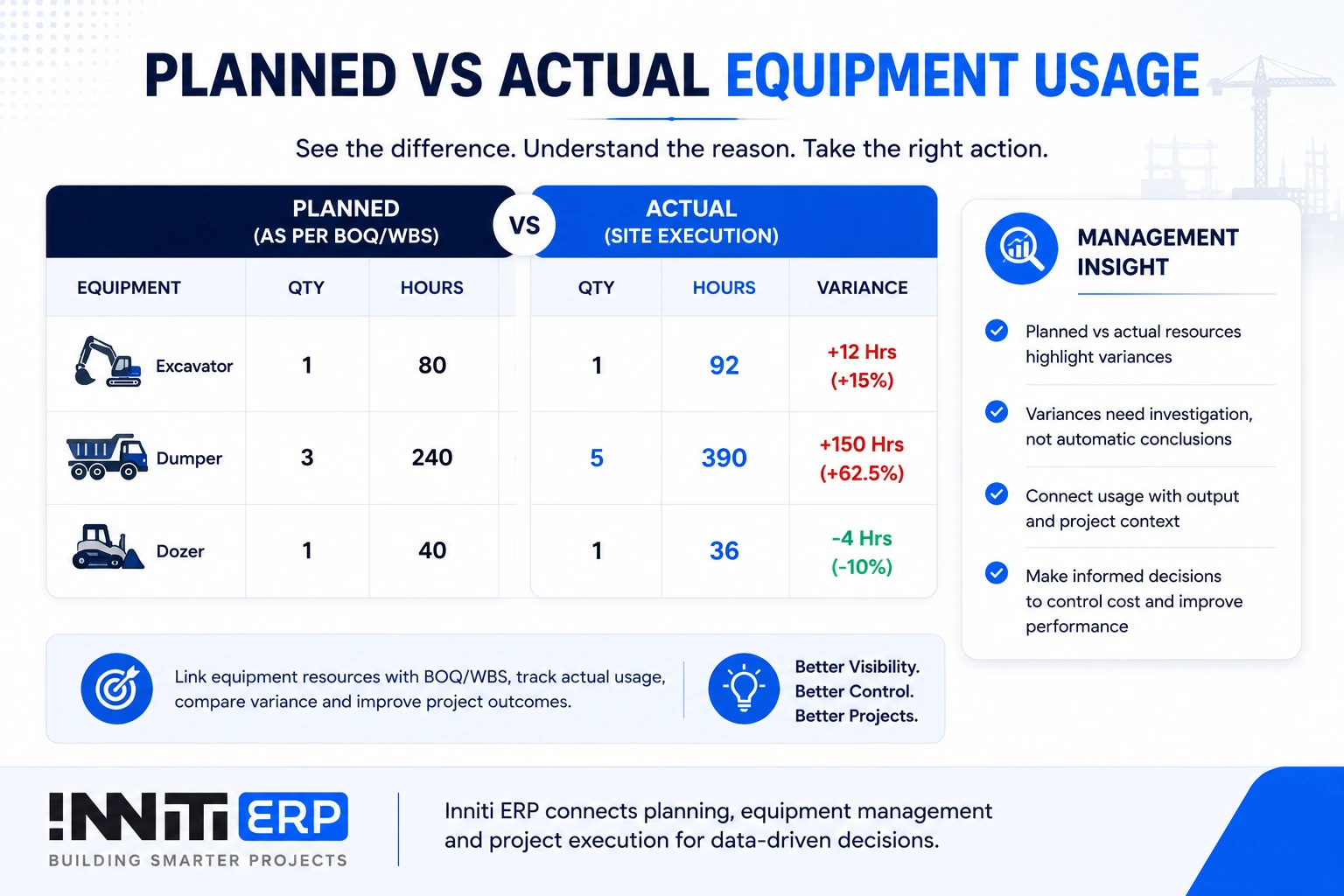

| Measure | Planned | Actual | Variance |
|---|---|---|---|
| Excavators | 1 | 1 | 0 |
| Dumpers | 3 | 5 | +2 |
| Excavator Hours | 80 | 92 | +12 |
| Dumper Hours | 240 | 390 | +150 |
| Work Quantity | 10,000 m³ | 10,500 m³ | +500 m³ |
But this is still not the final answer. Management needs to understand the relationships behind those figures.
In this example: actual work quantity increased by 5%. But: dumper hours increased by 62.5%. That difference deserves investigation.
Possible questions include:
- Did haul distance increase?
- Was dumper waiting time high?
- Did loading productivity decline?
- Were smaller-capacity dumpers deployed?
- Did road or site conditions reduce trip productivity?
- Was additional equipment used to recover the schedule?
This is where reporting moves from displaying numbers toward supporting management decisions.
Planned vs Actual Equipment Usage vs Equipment Utilization %
These concepts should not be confused.
Equipment Utilization % typically asks:
How much of available equipment time was actually used?
A simplified measure may be: Operating Hours ÷ Available Hours × 100
Planned vs Actual Equipment Usage asks:
How did the equipment resources actually consumed compare with what the project planned for the work?
The first is primarily an equipment operating metric. The second is a project resource-control comparison. Both are useful, but they answer different management questions.
For definitions of related equipment-management metrics, see Construction Equipment Management Terms Explained.
Why Should Equipment Utilization Be Connected to BOQ and WBS?
A construction machine is ultimately deployed to execute project work.
Equipment analysis becomes more useful when its usage can be associated with project, WBS, BOQ item, activity, work location, executed quantity, and relevant cost.
Instead of: EX-101 — 92 hours
management can interpret: EX-101 — Project A — WBS Earthwork — BOQ Excavation — 92 hours — Actual Quantity
This creates traceability between the resource and the work that required it.
The Inniti Approach: From Equipment Register to Equipment Resource Control
Inniti ERP is designed to manage construction equipment within the wider project execution and cost-control environment.
The important distinction is that equipment information does not need to remain isolated from BOQ, WBS and project planning.
With Inniti ERP, the management model can connect:
This allows project and management teams to examine not only which equipment was used, but also how actual equipment usage compares with the original resource plan.
How Inniti ERP Strengthens Construction Equipment Management
Equipment management is often treated as a collection of operational records:
These records are important, but construction management requires another dimension:
What was planned for the project work, and what did execution actually consume?
Inniti ERP can place equipment usage within the project resource plan, supporting reporting around questions such as:
Review equipment resources associated with planned work, activity or BOQ/WBS structure.
Capture and analyse equipment actually deployed during execution.
Compare resource quantities, usage or applicable measures against the planned requirement.
Maintain project and work context instead of treating equipment hours as standalone records.
Interpret resource consumption alongside actual project execution or work quantities where captured.
Use planned-versus-actual reporting to identify deviations requiring operational or commercial review.
The management cycle becomes:
Plan the resource → Deploy the resource → Record actual usage → Connect it to work → Compare → Analyse
Why Actual Equipment Hours Alone Can Hide Resource Variance
Consider two projects.
| Metric | Project A | Project B |
|---|---|---|
| Planned Excavator Hours | 100 | 60 |
| Actual Excavator Hours | 105 | 105 |
| Variance | +5% | +75% |
A traditional equipment-hours report shows 105 hours on both projects.
But the project-control interpretation is completely different. Project A is relatively close to its planned resource requirement. Project B has consumed substantially more excavator hours than planned.
Actual equipment hours without the planned project context can hide important resource deviations.
Equipment Variance Should Lead to a Question, Not an Automatic Conclusion
Useful reporting should help management identify exceptions. It should not automatically label every variance as waste.
When Actual Usage Is Greater Than Planned
Investigate whether quantity increased, productivity decreased, execution conditions changed, additional equipment was required, idle time increased, planning assumptions were inaccurate, or the schedule required acceleration.
When Actual Usage Is Lower Than Planned
Investigate whether productivity improved, equipment capacity changed, less work was executed, execution methodology changed, equipment was under-deployed, or the original estimate was conservative.
Both positive and negative variances require context. This distinction is essential for meaningful equipment-management reporting.
How Does Equipment Resource Variance Connect to Cost Control?
Equipment resource variance can eventually influence project cost.
If a BOQ activity was planned using three dumpers but consistently requires five, management may need to understand:
However, cost should not be interpreted independently of output. If additional resources generate proportionately greater output or accelerate critical project work, the commercial interpretation may be different.
For this reason, a useful management chain is:
rather than: More Equipment = Higher Cost = Poor Performance.
Detailed equipment costing should be evaluated using a defined organisational costing methodology.
What Data Is Needed for Planned vs Actual Equipment Analysis?
The exact data structure depends on the organisation and project, but useful information may include:
- project,
- BOQ/WBS/activity,
- planned equipment type,
- planned equipment quantity,
- planned hours or duration,
- actual equipment deployed,
- actual HMR/KMR,
- productive/idle hours where captured,
- actual work quantity,
- owned/hired status,
- applicable equipment cost information, and
- variance reason or management remark.
The quality of the analysis depends on consistent definitions and reliable site data.
For fuel-related equipment analysis, see Construction Equipment Fuel Consumption: Measure Fuel Against Productive Output.
For non-productive equipment time, see Equipment Idle Time in Construction: Formula, Causes & Control.
Common Mistakes in Planned vs Actual Equipment Analysis
Planned and actual resources should relate to comparable project scope.
Additional equipment usage may have a legitimate operational reason.
More equipment may also produce more work.
Duration and operating hours can reveal resource consumption that equipment quantity alone cannot.
Without project context, management knows what the machine did operationally but may not know what project requirement consumed the resource.
Planned hours, available hours, operating hours and productive hours should not be mixed without clear definitions.
Frequently Asked Questions
Planned Equipment Is an Estimate. Actual Equipment Is Evidence.
Planning establishes what the project expects to consume. Site execution reveals what it actually consumes.
The management opportunity lies in connecting the two:
When this information remains disconnected, equipment management is largely operational.
When it is connected, equipment data can become part of project resource and cost control.
