Inniti Technologies Private Limited

RMC Multi-Plant Order Allocation

Inniti Knowledge Center · RMC · Operations

RMC Multi-Plant Order Allocation and Capacity Planning

For multi-plant manufacturers, the closest plant is not necessarily the best plant. Allocation must account for existing commitments and realistic time-slot capacity.

Check slot-wise capacity. Validate materials & mixes. Confirm mixer readiness. Compare feasible plants.
Published by: Inniti Knowledge Center Reviewed by: Inniti ERP Product / RMC Domain Team Domain: Ready-Mix Concrete ERP & Plant Operations Last updated: October 2026

When a Ready-Mix Concrete (RMC) company runs more than one batching plant, every confirmed order raises a planning question: which plant should supply it?

For multi-plant manufacturers, the closest plant is not necessarily the best plant. A nearby plant may already be committed for the same time slot, short of a required material, or without an approved mix for the grade ordered.

Good allocation decisions account for existing commitments and realistic time-slot capacity, not just distance.

This article explains how multi-plant order allocation works, how to distinguish the different measures of plant capacity, and a practical workflow for assigning orders to plants.

Three RMC batching plants with transit mixers, linked to an order allocation screen that assigns concrete orders to plants
Multi-plant allocation weighs customer orders, plant capacity, raw material availability and transit mixer readiness before an order is assigned to a plant. The screen, order numbers and figures shown are illustrative, not an actual product screen or customer data.

What Is RMC Multi-Plant Order Allocation?

RMC multi-plant order allocation is the process of assigning customer concrete orders to suitable batching plants based on production capacity, delivery requirements, plant location, raw material availability and fleet readiness.

An allocation decision typically considers:

  • The concrete grade, quantity and delivery window requested by the customer.
  • Which plants are technically eligible to produce the required mix.
  • Each plant's practical capacity in the relevant time slot.
  • Production already committed to other customers in that slot.
  • Raw material stock and approved mix designs at each plant.
  • Transit mixer availability and distance to the construction site.

Allocating to the nearest plant by default can overload that plant, delay other committed deliveries, or leave capacity unused at plants that could have supplied the order.

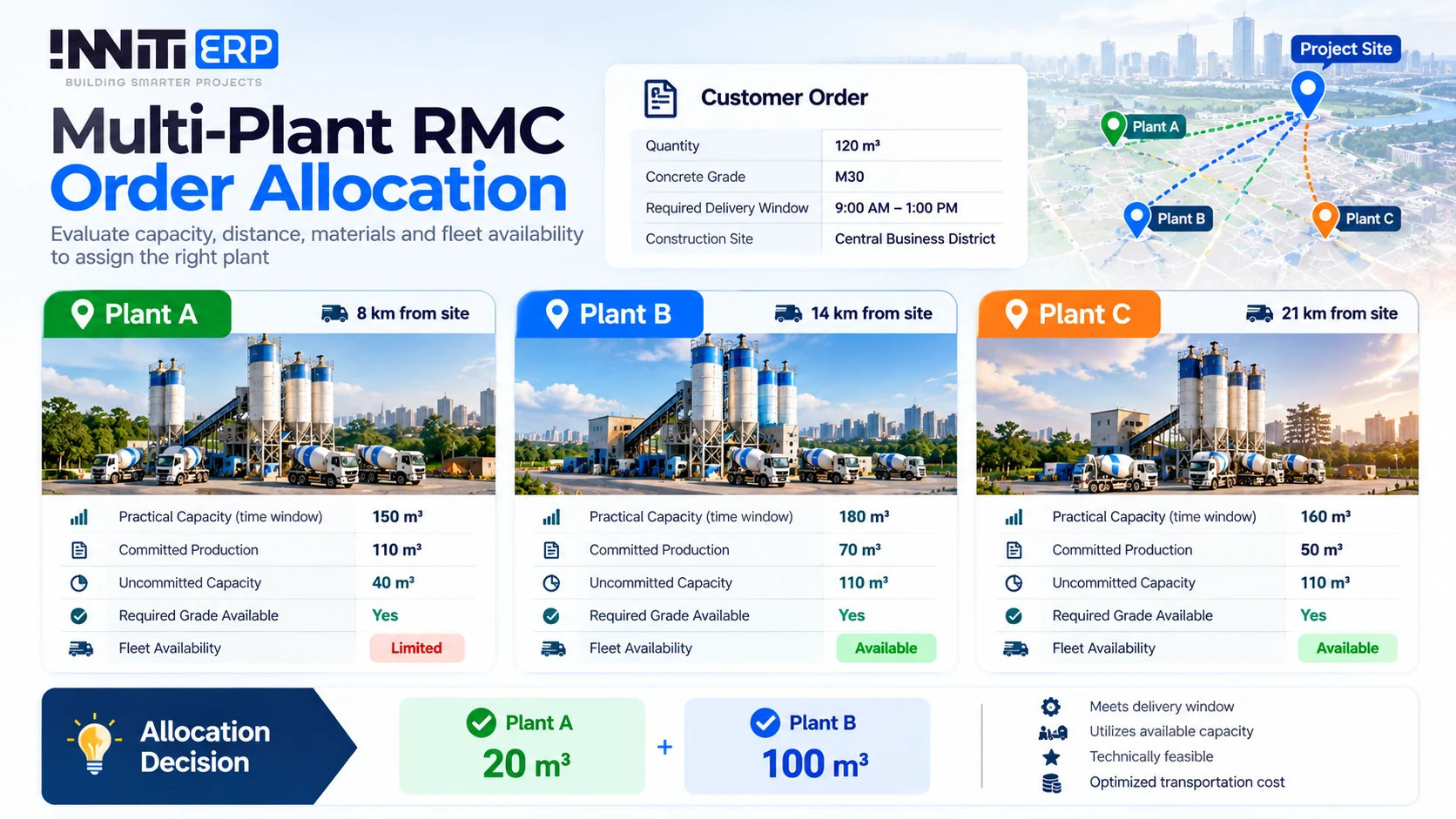

Three-Plant Allocation Example

A customer requests 120 m³ of M30 concrete during a morning delivery window. The company has three plants that can serve the site.

ParameterPlant APlant BPlant C
Distance to site8 km14 km21 km
Practical slot capacity150 m³180 m³160 m³
Existing commitments110 m³70 m³50 m³
Uncommitted slot capacity40 m³110 m³110 m³

Illustrative figures, not client performance results.

Plant A is the closest, but only 40 m³ of its morning capacity is uncommitted. Plants B and C each have 110 m³ free. No individual plant has 120 m³ uncommitted in the required window.

The planner's options include:

  • Negotiating a revised delivery window with the customer, so one plant can supply the full quantity.
  • Evaluating an approved split supply across two plants.
  • Reviewing flexible existing commitments that could be moved to free up capacity at one plant.

Any split supply requires grade, quality, fleet, delivery and customer checks before it is approved. Concrete from different plants must meet the same specification, and deliveries must be coordinated so the pour is not interrupted.

Three-plant RMC allocation comparison showing distance, practical capacity, committed production, uncommitted capacity, grade and fleet availability for Plants A, B and C
Illustrative example, not client data: one possible approved split supply, with 20 m³ from Plant A (limited fleet) and 100 m³ from Plant B. A split like this is valid only after the grade, quality, fleet, delivery and customer checks above.

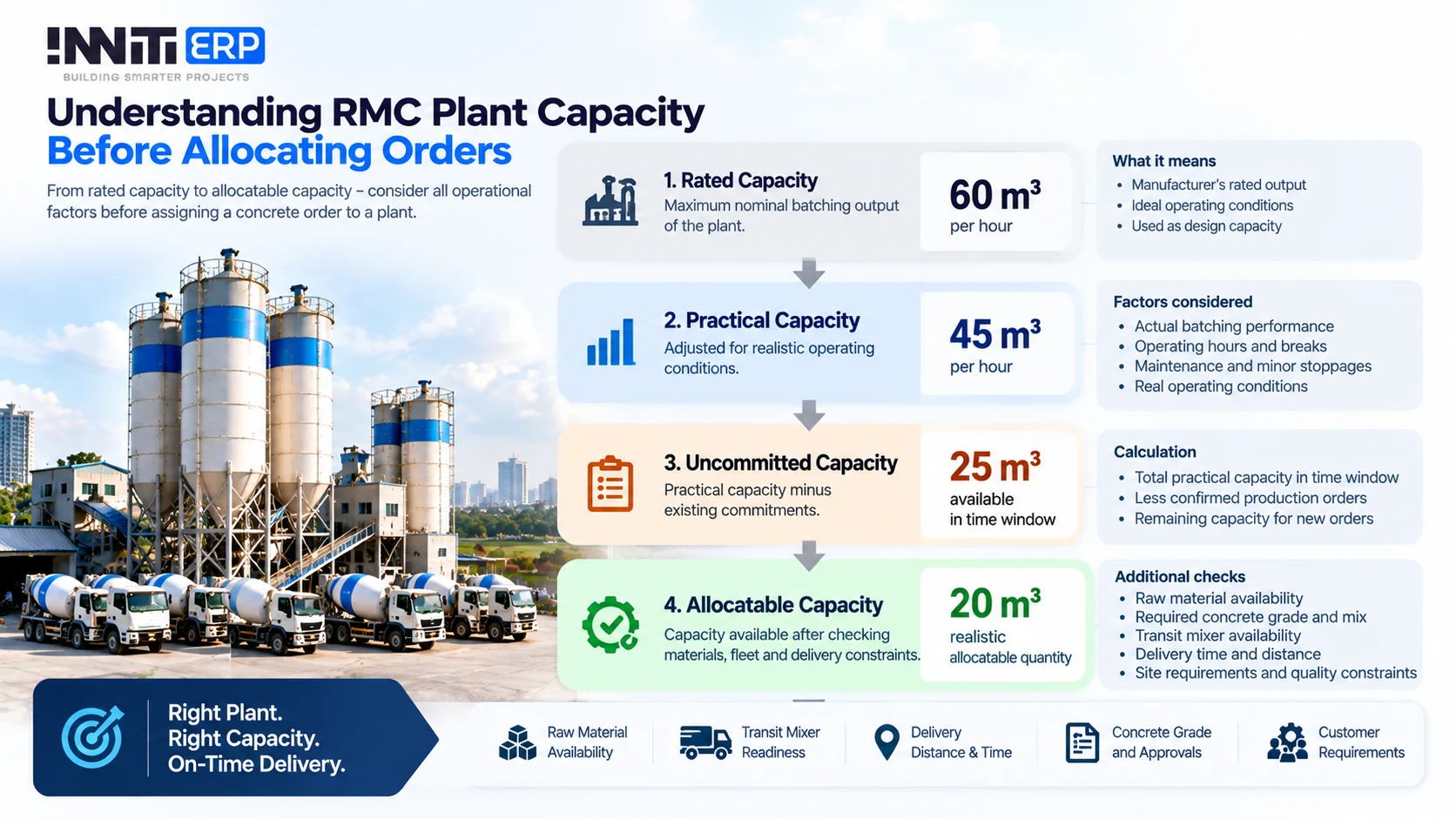

Capacity Definitions for Multi-Plant Planning

Allocation errors often start with an unclear definition of capacity. A plant's nameplate output is not the quantity a planner can actually assign.

RMC plant capacity funnel from rated capacity to practical, uncommitted and allocatable capacity before allocating an order
Each step narrows the quantity a plant can take on: rated → practical → uncommitted → allocatable. Figures are illustrative for a single one-hour slot and are separate from the three-plant example.
TermMeaning
Rated capacityNominal batching output in m³/hour.
Practical capacityAchievable output during the relevant period.
Uncommitted capacityPractical capacity minus committed production.
Allocatable capacityQuantity that can be assigned after material, mix-design, fleet and delivery checks.
Uncommitted Capacity = Practical Capacity − Committed Production

Allocatable capacity can be lower than uncommitted capacity. In the example above, Plant B shows 110 m³ uncommitted, but if it lacks an approved M30 mix or enough transit mixers for the window, its allocatable capacity for this order is lower.

Recommended Allocation Workflow

A consistent, step-by-step process makes allocation decisions repeatable and easier to review.

  1. Verify order specifications and delivery window. Confirm grade, quantity, site location and required timing.
  2. Identify technically eligible plants. Shortlist plants that can produce the required mix.
  3. Check slot-wise practical capacity and commitments. Work out uncommitted capacity for the requested window.
  4. Validate materials, approved mixes and transit mixer availability. Convert uncommitted capacity into allocatable capacity.
  5. Compare feasible plants on delivery reliability and cost. Consider distance, travel time and transport cost per m³.
  6. Approve the allocation and communicate it to production and dispatch. Make sure both teams work from the same plan.
  7. Monitor exceptions and retain allocation traceability. Record why each order went to a plant, and log any reallocation.

Once an order is allocated, the selected plant's dispatch team plans transit mixer trips against the site's receiving capacity. See RMC dispatch planning and transit mixer turnaround time.

Important KPIs for Multi-Plant Order Allocation

These indicators show whether allocation decisions are balancing load across plants and supporting reliable delivery.

KPIWhat it shows
Plant-wise capacity utilizationHow much of each plant's practical capacity is used
Peak-slot utilizationLoad on each plant during the busiest time slots
Allocation lead timeTime from order confirmation to approved allocation
Allocation exception rateShare of orders needing manual intervention or changes
Inter-plant reallocation volumeQuantity moved from one plant to another after allocation
On-time delivery performanceDeliveries arriving within the agreed window
Plant-wise transport cost per m³Delivery cost attributable to each plant's allocations

Reviewed together, these KPIs help distinguish a genuine capacity shortage from an allocation pattern that overloads some plants while others stay underused.

How Inniti ERP Supports Multi-Plant RMC Operations

Inniti ERP for RMC connects sales orders, production and batching records, plant-wise inventory, dispatch documents, fleet-related information and operational reporting.

For multi-plant planning, this means planners can review consistent records for:

  • Sales orders: Customer, grade, quantity, site and delivery schedule.
  • Production and batching records: What each plant has produced. (See batching plant ERP integration.)
  • Plant-wise inventory: Raw material stock at each plant.
  • Dispatch documents: Delivered quantities linked to orders and plants.
  • Fleet-related information: Transit mixer trip and delivery records.
  • Operational reporting: Plant-wise and order-wise information for management review.
Sales Order
Plant Allocation
Plant Inventory
Dispatch
Plant-wise Reports

Automated allocation rules, AI-based recommendations or optimization are advanced capabilities. Where an organization needs them, they require separate verification and depend on the implementation scope agreed.

Connect Orders, Plants and Dispatch in One System Explore how Inniti ERP for RMC gives planners consistent records across sales orders, production, inventory and dispatch.

Frequently Asked Questions About RMC Multi-Plant Order Allocation

What is multi-plant order allocation in RMC?

It is the assignment of customer orders to eligible batching plants based on available capacity, technical requirements and delivery feasibility.

Is the nearest RMC plant always the best choice?

No. Capacity, material readiness, fleet availability and delivery commitments may make another eligible plant preferable.

Can one order be supplied from multiple plants?

Potentially, subject to technical approval, compatible specifications, quality controls and coordinated delivery.

How does ERP help with RMC order allocation?

It can connect order, production, inventory and dispatch information so planners can review consistent operational records.

Conclusion

In a multi-plant RMC business, allocating each order to the nearest plant is a simple rule but often not the right one. Sound allocation starts from realistic, slot-wise capacity and existing commitments, then checks materials, mixes, fleet and delivery feasibility before a plant is chosen.

A clear workflow, well-defined capacity terms and a small set of KPIs help planners make decisions that are consistent, traceable and easier to improve over time.

Inniti ERP for RMC supports this by connecting sales orders, production, plant-wise inventory, dispatch and reporting within one operational system.

Editorial & Knowledge Note

This article is part of the Inniti Knowledge Center (IKC) — RMC Series and explains practical planning workflows used in ready-mix concrete operations.

The three-plant figures, the capacity figures and the split-supply decision shown in the illustrations are examples designed to explain the allocation logic. They are not Inniti ERP client performance results.

Product-specific statements describing Inniti ERP refer to capabilities of Inniti ERP for RMC; availability can depend on the modules, integrations and implementation scope configured for an organization.
