In the Ready-Mix Concrete (RMC) industry, timely delivery is just as important as concrete quality. Even a well-equipped batching plant with sufficient transit mixers can experience delivery delays, excessive vehicle waiting, and rising transportation costs.
The challenge is often not a shortage of transit mixers but poor coordination between production schedules, vehicle availability, traffic conditions, and construction-site readiness.
Effective RMC dispatch planning helps concrete manufacturers reduce avoidable waiting, improve fleet utilization, and maintain consistent deliveries to construction sites.
This article explains the common causes of RMC dispatch delays, how to calculate transit mixer turnaround time, and practical ways to improve delivery efficiency.
What Is RMC Dispatch Planning?
RMC dispatch planning is the process of coordinating concrete production, transit mixer allocation, delivery schedules, and construction-site requirements to ensure timely and efficient concrete deliveries.
An effective dispatch process considers:
- Customer orders, concrete grades, quantities, and delivery schedules.
- Batching plant production capacity.
- Transit mixer availability and carrying capacity.
- Travel distance, traffic conditions, and expected arrival times.
- Construction-site readiness and unloading capacity.
- Vehicle return times and subsequent trip allocation.
Unlike conventional transportation, ready-mix concrete delivery requires close coordination because concrete has limited workable time, depending on its mix design, admixtures, temperature, and applicable specifications.
Poor scheduling can result in unnecessary waiting, interrupted concrete pours, and increased operating costs.
Why Do Transit Mixers Experience Excessive Waiting Time?
Transit mixer waiting time is one of the most common operational challenges in RMC businesses.
A mixer may arrive at the construction site on schedule but remain idle because the concrete pump is unavailable, site preparations are incomplete, or another vehicle is still unloading.
| Common problem | Operational impact |
|---|---|
| Construction site not ready | Extended waiting before unloading |
| Multiple mixers arriving together | Vehicle queues at the site |
| Pump breakdown or slow unloading | Increased turnaround time |
| Traffic congestion | Unpredictable delivery schedules |
| Delayed batching or loading | Late dispatch from the plant |
| Poor vehicle return visibility | Inefficient allocation of mixers |
For example, if five transit mixers arrive at a site within 15 minutes but unloading each vehicle takes 20 minutes, several vehicles may remain idle while waiting for their turn.
The objective of dispatch planning is not to send the maximum number of mixers. It is to deliver concrete at a pace that matches the construction site's actual receiving capacity.
How to Calculate Transit Mixer Turnaround Time
Transit mixer turnaround time measures the time required for a vehicle to complete one delivery cycle and become available for its next assignment.
It is an important indicator of fleet efficiency.
Additional washing or operational delays should also be included when applicable.
Practical Example

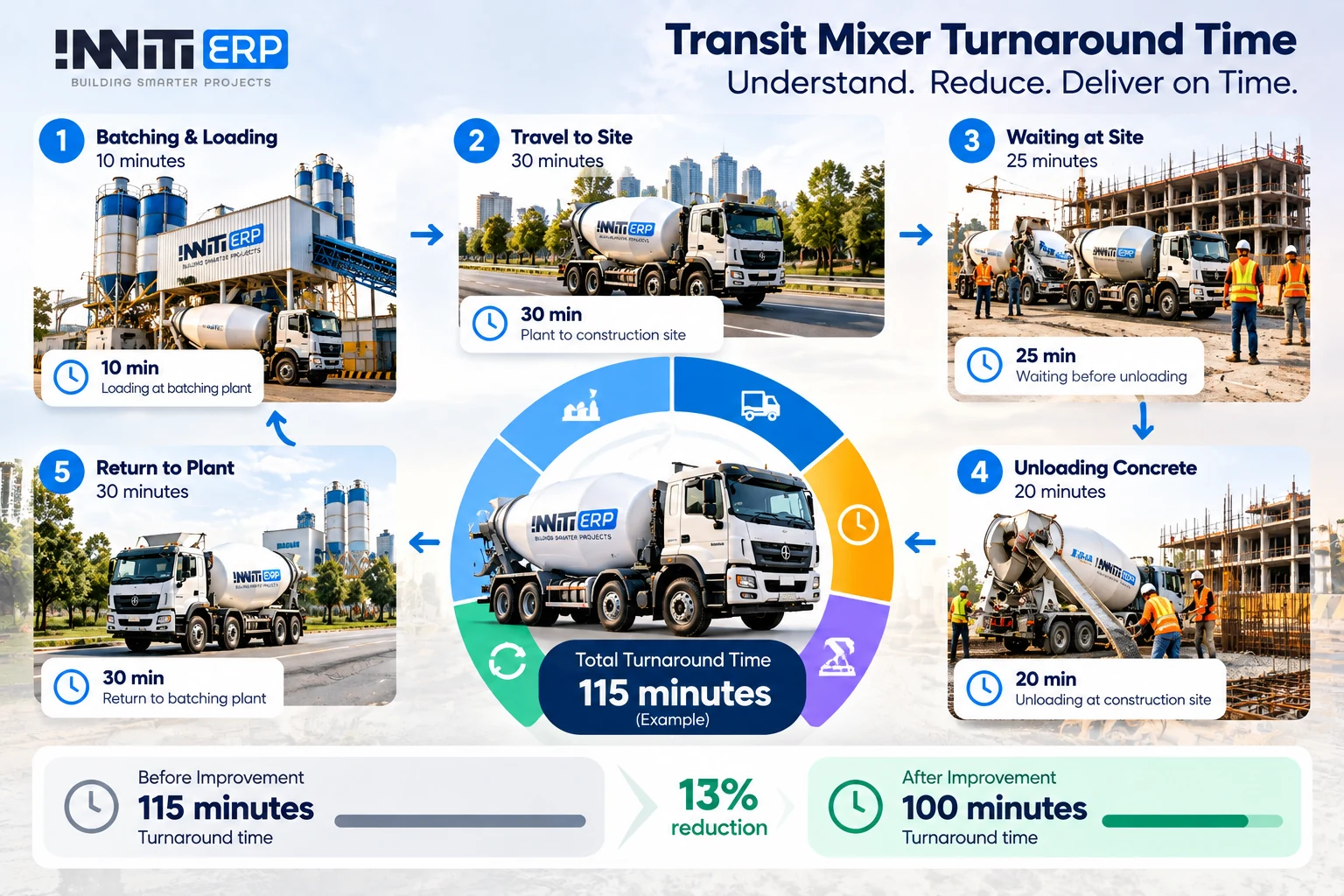

Consider a transit mixer completing a delivery from an RMC plant to a construction site.
| Activity | Time |
|---|---|
| Loading at batching plant | 10 minutes |
| Travel to construction site | 30 minutes |
| Waiting at site | 25 minutes |
| Concrete unloading | 20 minutes |
| Return to plant | 30 minutes |
| Total turnaround time | 115 minutes |
If improved scheduling and site coordination reduce waiting time from 25 minutes to 10 minutes, total turnaround time decreases to 100 minutes—an approximately 13% reduction in cycle time.
Illustrative calculation, not a measured Inniti ERP customer result.
Reducing unnecessary waiting can improve vehicle availability and create opportunities for additional deliveries without immediately increasing fleet size. Actual productivity gains depend on customer demand, plant capacity, traffic, and site conditions.
Five Practical Ways to Reduce RMC Dispatch Delays
1. Coordinate Production and Dispatch Schedules
Concrete batching should be aligned with confirmed customer orders, transit mixer availability, and planned delivery windows. Producing concrete before confirming vehicle and site readiness can create avoidable delays.
2. Confirm Site Readiness Before Releasing Vehicles
Dispatch teams should verify pump availability, unloading arrangements, labour readiness, and site access before sending transit mixers. This simple coordination can prevent significant waiting at construction sites.
3. Monitor Transit Mixer Movement and Return Times
GPS or Vehicle Tracking System (VTS) integration helps dispatchers monitor vehicle movement and estimate return times. Better visibility supports more informed allocation of available mixers for upcoming deliveries.
4. Schedule Deliveries According to Unloading Capacity
Instead of dispatching multiple vehicles simultaneously, RMC plants should plan arrival intervals according to the site's actual unloading speed. This helps reduce queues while maintaining a continuous concrete supply.
5. Analyse Delays and Turnaround Time Regularly
Dispatch managers should review waiting time, trip duration, delivery delays, and vehicle utilization. Identifying recurring problems by plant, vehicle, customer, or construction site helps management take corrective action.
Important KPIs for RMC Dispatch Management
RMC businesses should monitor a few meaningful performance indicators rather than relying only on total dispatch quantity.
| KPI | What it measures |
|---|---|
| Transit mixer turnaround time | Average time required to complete a delivery cycle |
| Site waiting time | Time spent waiting before unloading |
| On-time delivery percentage | Deliveries arriving within the agreed time window |
| Trips per mixer per day | Daily productivity of active transit mixers |
| Average unloading time | Time required to unload concrete at a site |
| Fleet utilization | Productive vehicle time relative to available operating time |
These KPIs help identify whether delays originate from plant operations, transportation, or construction-site activities.
For multi-plant RMC businesses, plant-wise and vehicle-wise comparisons can reveal operational differences that are difficult to identify through manual reporting.

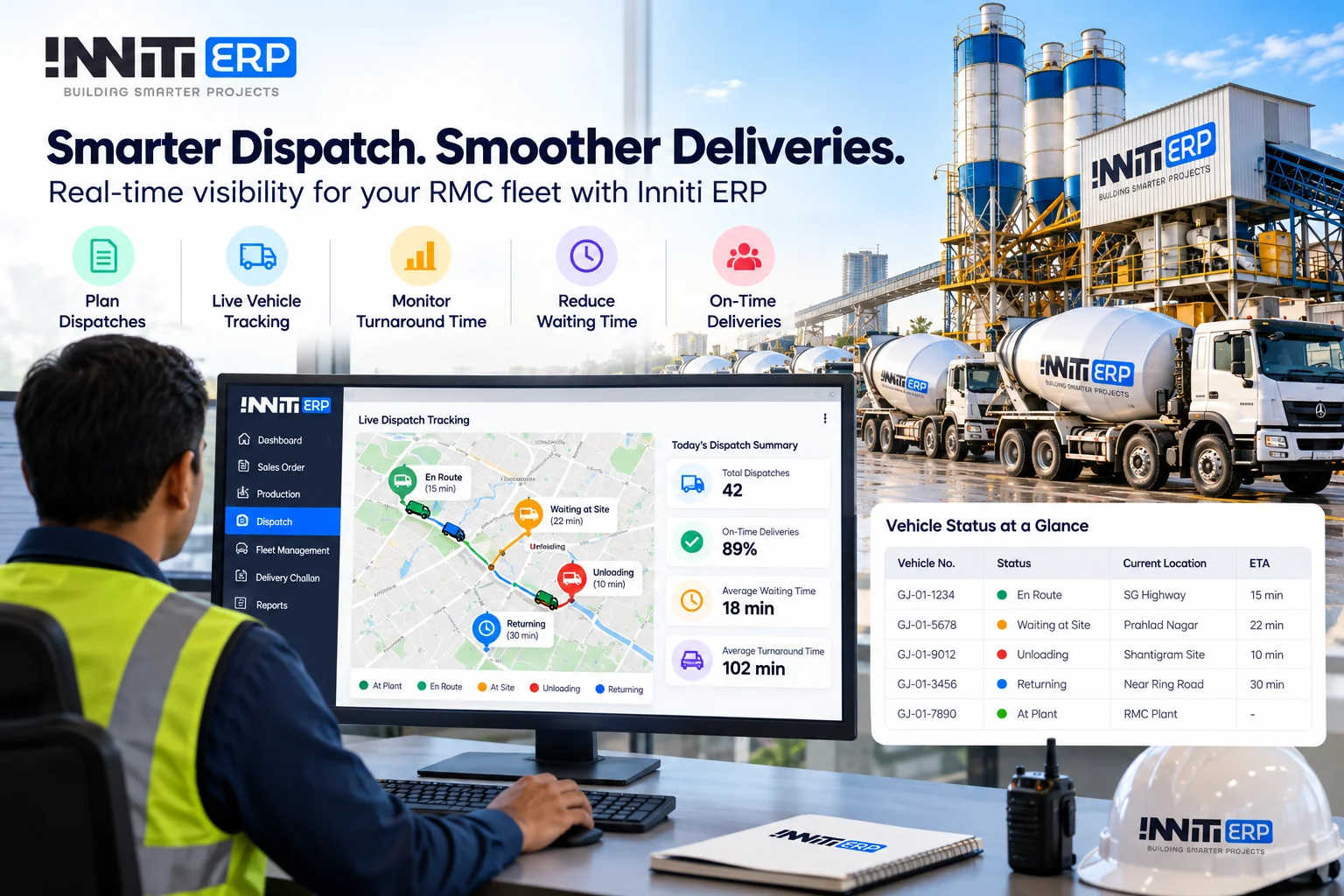

How Inniti ERP Helps Improve RMC Dispatch Management
Inniti ERP for RMC is an industry-specific ERP solution designed to connect ready-mix concrete sales, production, dispatch, delivery, and fleet operations.
Its integrated approach supports:
- Order-to-dispatch visibility: Connecting customer orders, concrete grades, quantities, and delivery records.
- Batching plant integration: Linking production information with dispatch operations. (See batching plant ERP integration.)
- Transit mixer management: Maintaining vehicle-wise trip and delivery records.
- GPS/VTS integration: Supporting vehicle tracking through compatible tracking systems.
- Delivery challan management: Connecting dispatched quantities with delivery documentation.
- Operational reporting: Providing dispatch and fleet information for management review.
With accurate trip-event data, RMC businesses can analyse delivery performance, identify excessive waiting, and make better fleet allocation decisions.
For companies operating multiple batching plants, centralized information also supports more consistent operational monitoring.
Frequently Asked Questions About RMC Dispatch Planning
What is RMC dispatch planning?
RMC dispatch planning is the process of scheduling concrete production, transit mixer allocation, and deliveries according to customer requirements, vehicle availability, and construction-site readiness.
How can RMC plants reduce transit mixer waiting time?
RMC plants can reduce waiting by confirming site readiness, coordinating batching with dispatch, staggering vehicle arrivals, monitoring transit mixer movement, and analysing recurring delays.
What is transit mixer turnaround time?
Transit mixer turnaround time is the total time required to complete one delivery cycle, including loading, travel, waiting, unloading, and return to the plant.
How does GPS tracking help RMC dispatch operations?
GPS tracking provides visibility into transit mixer locations and movements, helping dispatch teams identify delays, estimate vehicle return times, and coordinate upcoming deliveries.
Can RMC ERP software help improve fleet utilization?
Yes. RMC ERP software can connect order, production, dispatch, and vehicle information, helping managers identify inefficient trips, monitor turnaround times, and improve vehicle allocation decisions.
Conclusion
Efficient RMC dispatch planning is not simply about increasing the number of transit mixers or accelerating concrete production. It requires better coordination between batching plants, dispatch teams, vehicles, and construction sites.
By monitoring turnaround time, reducing unnecessary waiting, and improving delivery scheduling, RMC businesses can improve fleet productivity and delivery reliability.
Inniti ERP for RMC supports this approach by connecting production, dispatch, delivery, and fleet information within an integrated operational system.
Editorial & Knowledge Note
This article is part of the Inniti Knowledge Center (IKC) — RMC Series and explains practical dispatch and fleet workflows used in ready-mix concrete operations.
The 115-minute and 100-minute turnaround figures are worked examples designed to explain the calculation. They are not measured Inniti ERP customer results, and actual outcomes depend on demand, plant capacity, traffic and site conditions.
Product-specific statements describing Inniti ERP refer to capabilities of Inniti ERP for RMC; availability, including GPS/VTS integration, can depend on the modules, integrations and implementation scope configured for an organization.
